Home / Developers / Progressive Rollouts Playbook

Guides and playbooks

Progressive Rollouts Playbook

Step-by-step playbook for the full rollout lifecycle — configure, monitor, expand, and complete — covering both Manual and Automatic modes.

Prerequisites

  • A flag created and published to the target environment
  • ZENMANAGE_SERVER_KEY exported in your server environment, or VITE_ZENMANAGE_CLIENT_KEY in your front-end build
  • Baseline error and latency metrics captured so you have something to compare against during the rollout

Choose Manual or Automatic mode

Before you save your first configuration, decide which mode fits the risk profile of the change.

Manual mode

You advance the percentage yourself. Use Manual when the feature needs a human decision at each stage — for example, when you need to read a dashboard, run a query, or hold a team sync before proceeding. Manual gives you maximum control and is the right default when the rollout touches payment flows, data migrations, or any path where a machine advancing the schedule would be inappropriate.

Automatic mode

Zenmanage advances the percentage on the schedule you configure. Use Automatic for low-risk UX changes, internal tooling, or infrastructure improvements where you trust the rollout to proceed overnight or over a weekend without manual intervention. You can still pause, override, or complete early at any time.

When in doubt, start in Manual mode and switch to Automatic after the first stage confirms the change is stable.

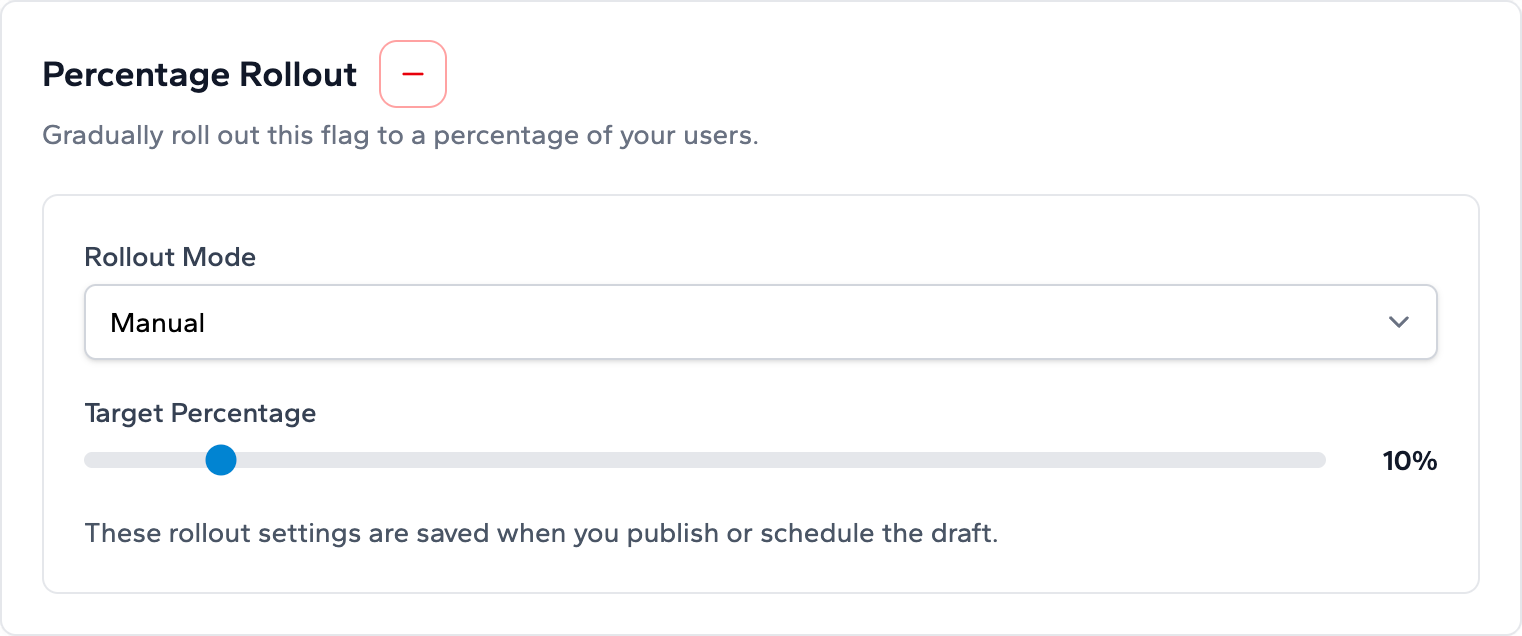

The Percentage Rollout panel with Manual mode selected and the target percentage slider set to 10%
The Percentage Rollout panel in Manual mode with the target percentage set to 10%. Drag the slider to your desired initial percentage, then publish or schedule the draft to activate the rollout.

Phase 1 — Configure

  1. 1. Set the rollout target. Choose the flag value to roll out — typically the value that enables the new behavior. Users who are not yet in the rollout receive the current published default.
  2. 2. Set the initial percentage. For high-risk changes, start at 1–5 %. For internal or low-risk changes, starting at 10–20 % is common. There is no universal right answer; the goal is a canary window small enough to catch a problem before it reaches most users.
  3. 3. Choose your mode. Select Manual or Automatic using the guide above.
  4. 4. Configure stages (Automatic only). Define the percentage and duration for each stage. A seven-stage schedule is a common starting point: 2 % → 5 % → 10 % → 20 % → 40 % → 70 % → 100 %, with a soak period at each stage long enough to detect regressions in your monitoring.
  5. 5. Save and activate. The rollout moves to Active state. Zenmanage immediately begins serving the rollout value to the configured percentage of users in that environment.

Keep a safe path in code

Your code should always handle the case where the rollout value is not yet received — for example, during a network interruption or a cache miss. Supply an inline default that matches the current safe behavior so users not in the rollout are unaffected.

How deterministic bucketing works

When a rollout is active, Zenmanage assigns each user a position in a virtual bucket by hashing their context identifier — typically the user ID — against the flag key. This produces a stable number between 0 and 100 that is the same every time for the same user.

If the rollout is at 10 %, only users whose bucket number falls in the lowest 10 % of the range receive the new value. When you advance to 20 %, the same users still receive the new value — and the next 10 % of the bucket range is added on top. Users do not flip in and out of the rollout as the percentage increases.

This matters for incident response: if a bug is reported while the rollout is active, you can identify affected users by knowing the current rollout percentage and which identifiers fall inside it. It also matters for UX during expansion: a user who qualified at 10 % stays qualified when you move to 20 %, because the next bucket range is added instead of reshuffling everyone already in the rollout.

Changing the context identifier changes the bucket

If your application sends a different identifier for the same person — for example switching from an anonymous session ID to a user ID at login — the bucket assignment will change. Keep the rollout identifier consistent across the user's session to avoid unexpected flips.

Phase 2 — Monitor

The most important period of any rollout is the first stage. Watch the following signals for at least one full traffic cycle — typically 24–48 hours for consumer products — before advancing.

  • Error rate: compare the error rate during the rollout window against the baseline you captured before launching. A spike of more than one or two standard deviations is the strongest signal to pause.
  • Latency: look at p95 and p99 latency, not just average. The new code path may be slower only for a subset of requests that are invisible in average metrics.
  • Business events: monitor conversion, activation, or transaction events if the flag touches a user journey. A drop in conversion that correlates with the rollout start date is a signal even if error rates look clean.
  • Support volume: watch for a spike in support tickets or in-app feedback. User-visible bugs rarely show up only in server metrics.

For Automatic mode, also confirm that the progress indicator is advancing on the expected schedule.

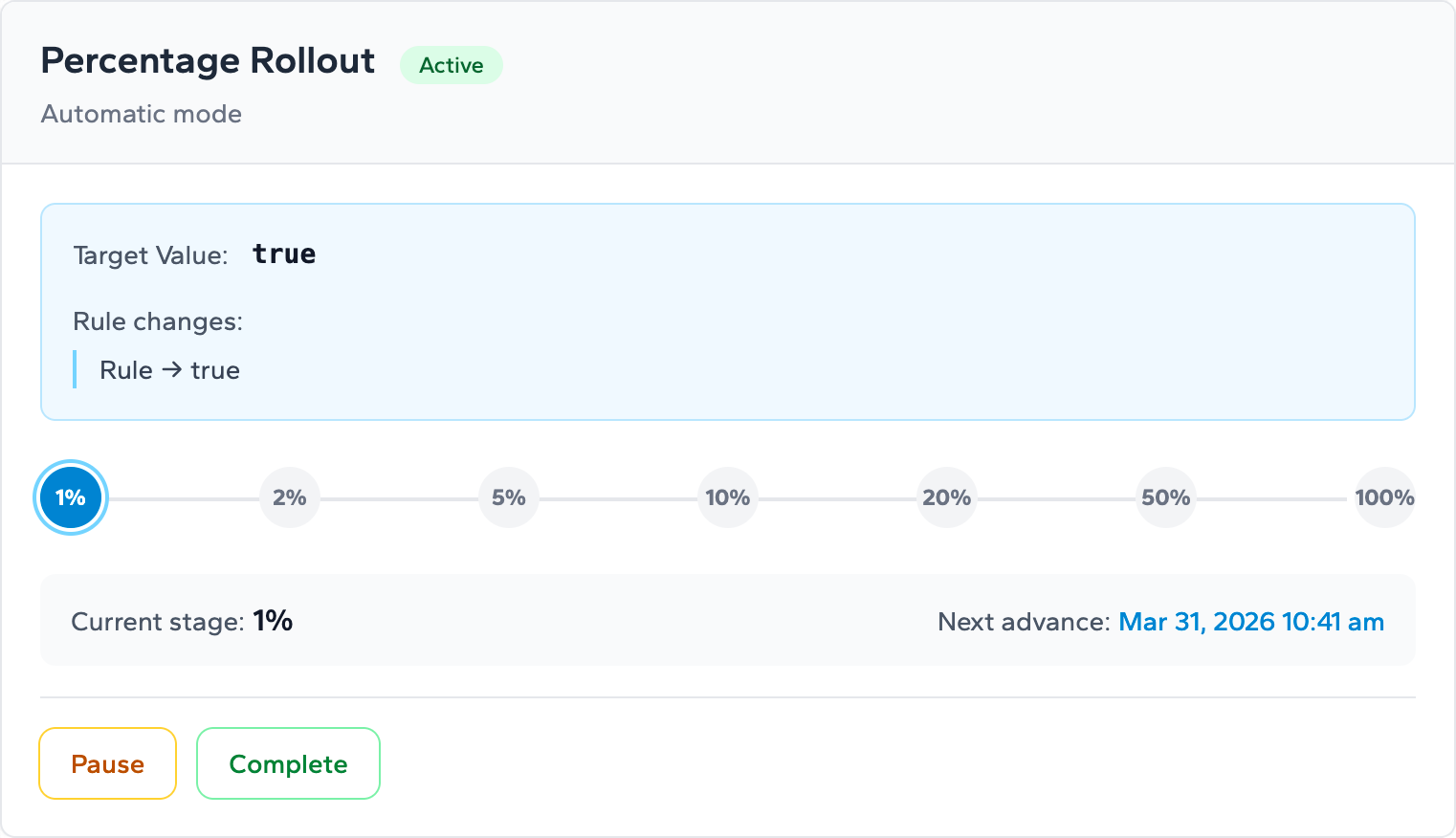

Active Automatic rollout at the 1% stage with a seven-stage progress indicator and next advance date shown
An active Automatic rollout at the 1% stage. Each node on the progress indicator represents a configured stage — the filled circle is the current stage. The next advance date tells you when Zenmanage will move to the 2% stage automatically.

When to pause

Pausing stops the rollout and serves the previous target rules to everyone in that environment. The rollout percentage is preserved so you can resume later, but while paused the rollout itself is not serving traffic. Use Pause when:

  • Metrics are trending in the wrong direction but you are not yet certain enough to roll back completely.
  • An unrelated incident is active and you want to stop introducing additional variables.
  • A planned maintenance window is approaching and you prefer a clean baseline before it.
  • You are waiting for a team member or stakeholder review that cannot happen until the next business day.

Resume when the blocking concern is resolved. The rollout continues from where it paused — it does not restart the stage timer in Automatic mode.

Pause is not rollback

Pausing is effectively a temporary return to the pre-rollout ruleset for everyone. Use it when you want to stop rollout exposure without permanently completing or deleting the rollout. If you need a broader emergency mitigation path outside the rollout flow, use the kill-switch pattern described in the Kill Switch and Incident Rollback guide.

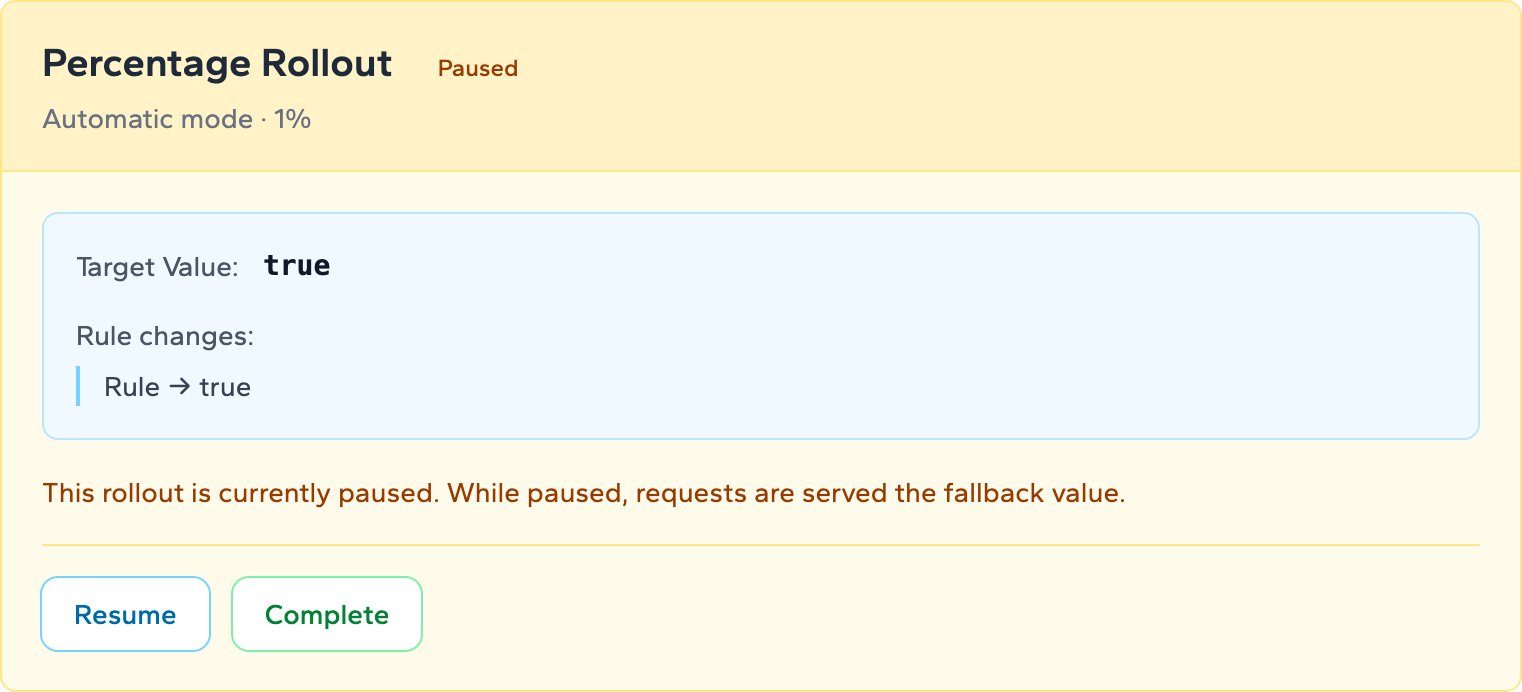

Paused rollout panel with amber background and the message that requests are served the fallback value while paused
A Paused rollout. The amber banner confirms that all requests are receiving the pre-rollout fallback value — the rollout percentage is preserved so you can Resume from exactly where you left off, or Complete to end the rollout permanently.

Phase 3 — Expand

Once a stage looks stable, advance the percentage.

Manual expansion

Use the percentage slider to move to the next stage. There is no prescribed cadence — you set the pace. After each advance, resume monitoring before moving further. Double the percentage at each step as a common heuristic: 5 % → 10 % → 20 % → 40 % → 80 % → 100 %.

Automatic expansion

Zenmanage advances through the stages you defined at configuration time. You do not need to take any action unless you want to pause, skip a stage, or complete early. Check the progress indicator periodically to confirm the schedule is running as expected.

In both modes, the soak time at each stage is more important than how quickly you advance. A rollout that spends 24 hours at 10 % before moving to 20 % is more reliable than one that steps from 1 % to 100 % in an hour.

Phase 4 — Complete

A rollout is complete when the new value should become the permanent behavior for all users. Completing the rollout promotes the rollout value to the flag's published default and removes the rollout configuration.

  1. 1. Verify 100 % or complete early. If you are at 100 % and metrics look good, use the Complete action. In Automatic mode you can also complete early at any stage if you are confident the change is safe for all users.
  2. 2. Remove the flag from code. After completion, plan a code cleanup ticket. The inline default in your application is now redundant — the flag value is the published target. Leaving flags in code indefinitely creates the technical debt the governance checklist is designed to prevent.
  3. 3. Archive the flag. If the flag will never be needed again, archive it. This keeps your flag list clean and prevents accidental reuse of an old key.

Completing early

You can complete an Automatic rollout at any stage before it reaches 100 %. This is appropriate when early data is so positive that waiting through remaining stages adds risk (for example, by leaving users on an older code path longer than necessary) rather than reducing it.

Once a rollout is complete, Zenmanage records that transition in the flag history so you can review when the rollout finished, who completed it, and how the flag moved from rollout state back to the normal published target flow.

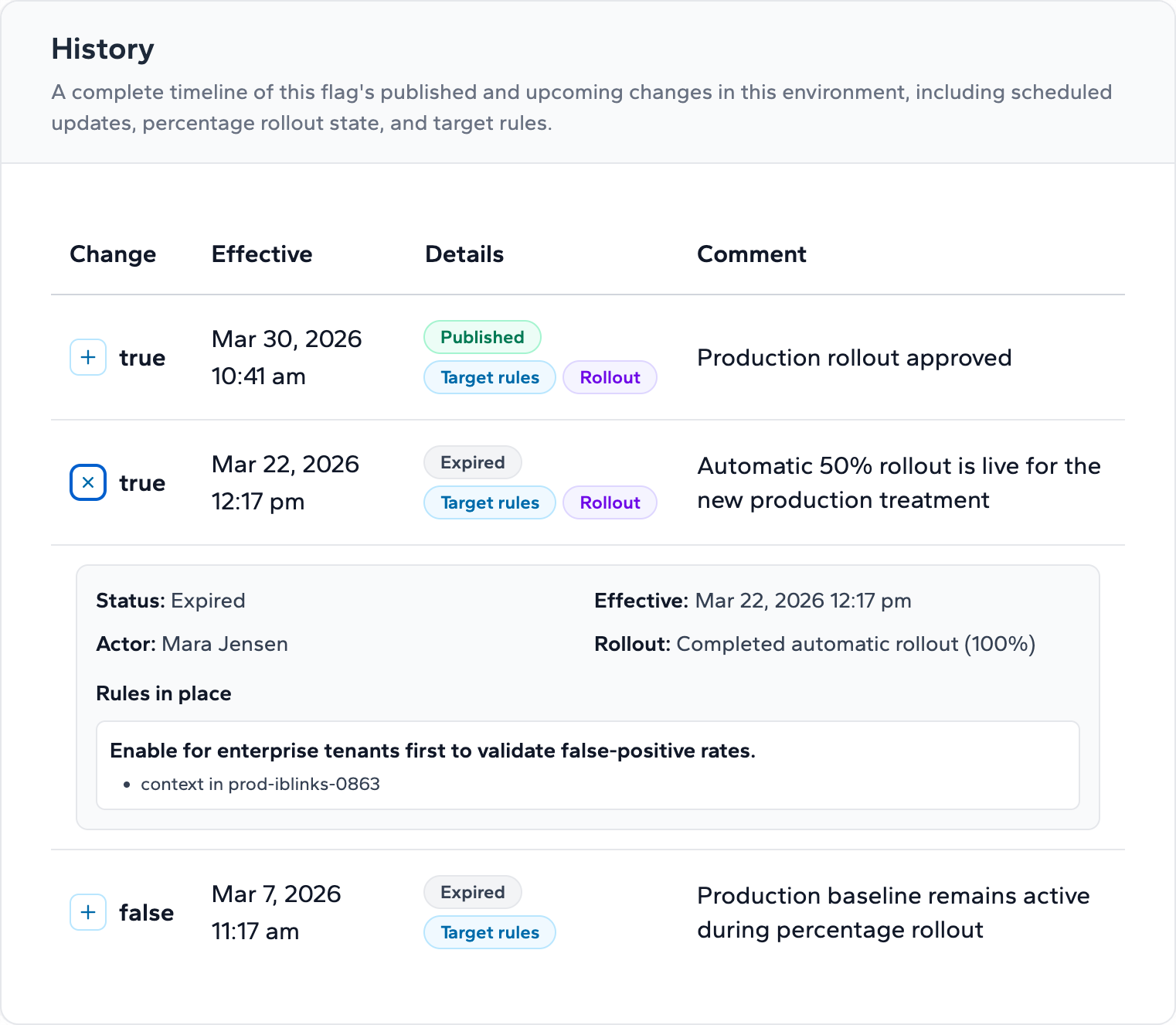

Flag History tab showing a completed automatic rollout entry with actor, effective date, and rollout completion details
The flag History tab after a completed Automatic rollout. Each entry records who made the change, when it took effect, and the rollout state at that point — including the final “Completed automatic rollout (100%)” entry that confirms the promotion.

Quick-reference decision matrix

Situation Recommended action
Error rate spikes but cause is unknown Pause immediately; investigate before proceeding
Error rate spike is confirmed unrelated Resume; document the correlation in incident notes
Metric regression clearly caused by the rollout Use kill switch to revert; do not just reduce percentage
All metrics healthy at current stage Advance to next stage after soak period
Automatic rollout advancing too fast Pause; reconfigure stage durations; resume
Early data is strongly positive Complete early to reduce time on split code paths
Feature at 100 % and stable for > 1 week Complete rollout; schedule code and flag cleanup
